Project Overview

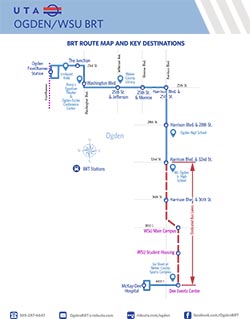

Bus Rapid Transit or BRT combines the capacity and speed of light rail with the lower cost construction of an integrated bus system. Once complete, Ogden Express (formerly route 603) will provide riders a clean-air ride in an electric bus from the Ogden FrontRunner Station, through downtown, along dedicated bus lanes in the center of the road on Harrison Boulevard and through the Weber State University campus, and to McKay-Dee Hospital. When operational, riders will be able to catch the bus every 10-15 minutes on weekdays and 15-30 minutes on weekends. The project will benefit the community by reducing vehicle trips, supporting the economy and providing transportation choices.

Download Quick Facts

Download Frequently Asked Questions

Transit Improvements



Roadway/Pedestrian/Bike Improvements



23rd Street
Road reconstruction


Washington Blvd
Road reconstruction & pedestrian crossings


25th Street
Road reconstruction
Harrison Blvd
New widened roads, pedestrian crossings
& adding turn lanes on 32nd & 36th Streets

WSU Campus
New shared use path with road reconstruction
pedestrian crossings and bike lanes

4400 South
Road reconstruction


Construction

Utah Transit Authority, Jacobs Engineering, AECOM, WCEC, and Stacy and Witbeck have partnered to design and construct the Ogden Express (OGX) line over the next three years. Project segments will be constructed simultaneously in multiple locations to ensure project completion in a timely manner.

Updates this week:

In observance of the Independence Day holiday, construction activities will be suspended Saturday (July 2) through Monday (July 4). Work will resume on Tuesday (July 5).

Washington Blvd.

  • OGX station platform work will resume with canopy installation in summer 2022.

23rd Street

  • Preliminary utility (water, sewer) relocations are scheduled to begin Tuesday, July 12 for the reconstruction of 23rd Street between Lincoln and Grant avenues. This block will be closed to all traffic through fall 2022. Wall Ave. to Lincoln Ave. reconstruction is expected to begin in fall 2022 and Grant Ave. to Washington Blvd. by early 2023.
  • In preparation to remove the asphalt, crews plan to lower manholes between Lincoln and Grant avenues next Wednesday and Thursday (July 6-7). This will be a moving operation and the road will remain open.

25th Street

  • 25th Street is open to local traffic and on-street parking between Washington Blvd. and Adams Ave. Pending concrete availability, crews will install sidewalk on the north side of the street and then sidewalk demo will begin on the south side. Watch for pedestrian detours.
  • Crews plan to raise utility manholes in the Adams Ave. intersection next Wednesday and Thursday (July 6-7). The intersection will remain open during this work.
  • Roadway excavation, subgrade placement and grading continue between Adams and Jefferson. Prep for curb/gutter and street light foundations is expected to begin next week.
  • OGX station platform and utility work continues near the Jefferson Ave., Monroe Blvd. and Harrison Blvd. intersections, with sidewalk detours for this work.
  • 25th Street is closed between Harrison Blvd. and Van Buren Ave. for station work. The UTA bus stops on the 603 route at 25th & Harrison are closed and riders may board the bus on Harrison Blvd. just south of 25th Street and also at 24th & Jackson Ave.
  • Not related to the OGX project, Ogden City is completing roadway improvements on Ogden Ave. and waterline replacements on Adams Ave. between 25th and 26th streets and on 26th Street between Adams Ave. and Ogden Ave. More information is available by calling the City's project hotline: (800) 292-3557 or emailing marty.asay@wcg.us.

Harrison Blvd.

  • OGX station construction is underway just south of the 28th Street intersection (Ogden High School). Night work is planned next Wednesday (July 6) and Friday nights (July 8) for waterline relocationand street repaving, with lane restrictions on Harrison Blvd. after 8 p.m. The west side of the 28th St. intersection is closed through mid-July. Storm drain installation and station platform work continue next week during daytime hours.
  • Waterline service connections are complete on northbound Harrison Blvd.
  • Excavation, road base placement and prep for concrete flatwork (curb/gutter/sidewalk) continue on southbound Harrison Blvd. between 35th and 36th streets. Business accesses are maintained.
  • Pending concrete availability, curb/gutter will be installed at Harrison Plaza (north of 32nd Street).
  • Traffic is shifted to the east side of the road between 31st and 37th streets and two lanes are maintained in each direction during daytime hours. Business and residential accesses are maintained.
  • Crews plan to switch traffic to the west side of the road for northbound Harrison Blvd. reconstruction to begin by mid-July.

Weber State University

  • Preliminary utility relocations (power) continue on the new OGX alignment between Harrison Blvd. and Lindquist Plaza.
  • Roadway grading, subgrade placement, paving prep and curb/gutterinstallation continue on the new OGX alignment between Village Dr., 4225 S., Country Hills Dr. and the Ice Sheet. Paving is planned end of next week between the Ice Sheet and Country Hills Dr. Intermittent flagging operations are possible at intersections for this work.
  • OGX station canopy and information kiosk installations continue at Village Drive.
  • Station canopy installation and irrigation and landscaping work continue on central campus.
  • OGX station canopy installation and prep for final concrete pavingcontinue next week at the Dee Events Center.
  • 4400 S. is closed between Harrison Blvd. and the Dee Events Center parking lot for repaving.
